Primavera P6 Resource Curves Explained

Primavera P6 Resource Curves
Primavera P6 Resource Curves

Resource curves are used to model the resource or cost loading of an activity within the work schedule. Resource curves can be linear, back loaded, front loaded, trapezoidal, triangular etc. If you have an activity with a non-linear resource loading, it is possible crate a custom resource curve to model it’s resource distribution. In this article, we will demonstrate how to create a custom resource curve by using Oracle Primavera P6 Resource Curves feature.

Why Do We Use Primavera P6 Resource Curves ?

In a work schedule, if the resource loading or cost loading of an activity is not uniform, resources curves can be used to represent the real distribution. For example let’s say that you have one activity for brick laying and you are sure that at the beginning, your productivity will be less, in the middle productivity will be more and at the end the productivity will again be less. In order to model real resource loading, in Primavera P6, you can select trapezoidal resource curve instead of linear.

Primavera P6 Resource Curves

Let’s assume that you have a sample pipeline schedule. All the activities Clearing and Grading, bending, stringing, welding etc. are logically tied. (Figure 1).

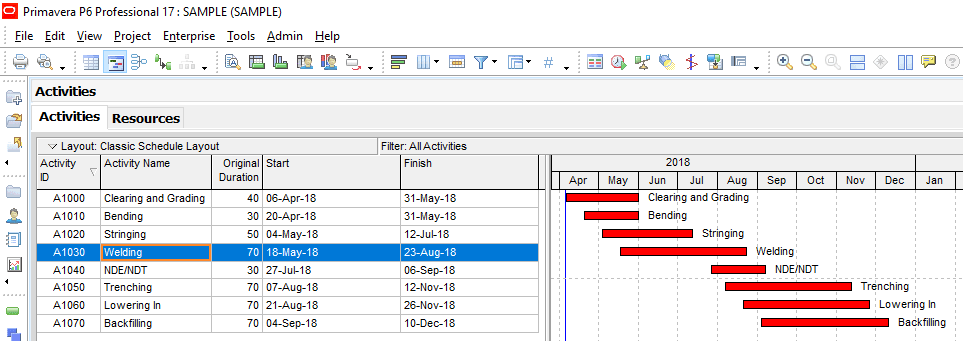

Figure 1 Sample Pipeline Schedule
Primavera P6 Resource Curves – Figure 1 Sample Pipeline Schedule

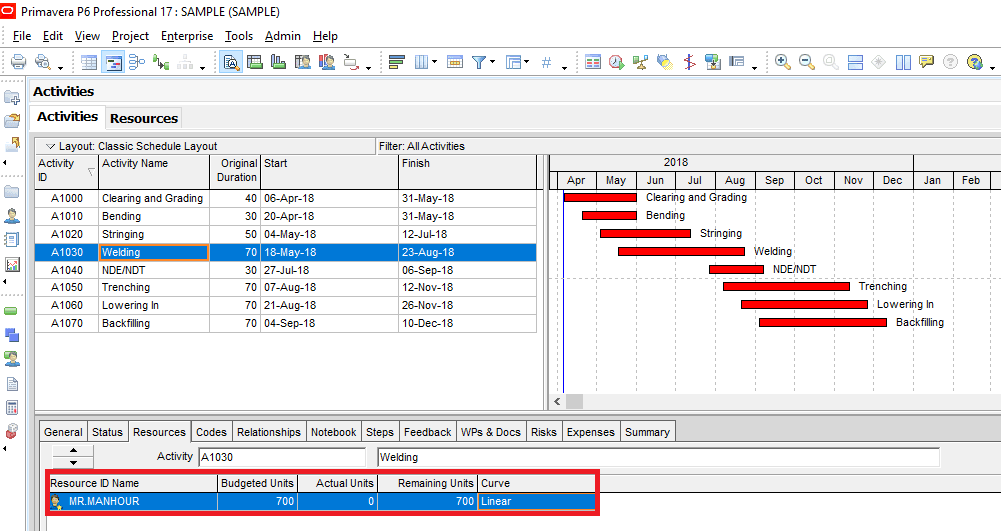

And you assigned a “Manhour” labour resource to each of the pipeline activities. (Figure 2).
If you don’t know how to assign a resource in Primavera P6, please read this article.Primavera P6 Resources: Creating and Assigning

Figure 2 Manhour Resource
Primavera P6 Resource Curves – Figure 2 Manhour Resource

Select Enterprise | Resource Curves from the main drop down menu at the top of the screen. This will display the Resource Curves window. (Figure 3)

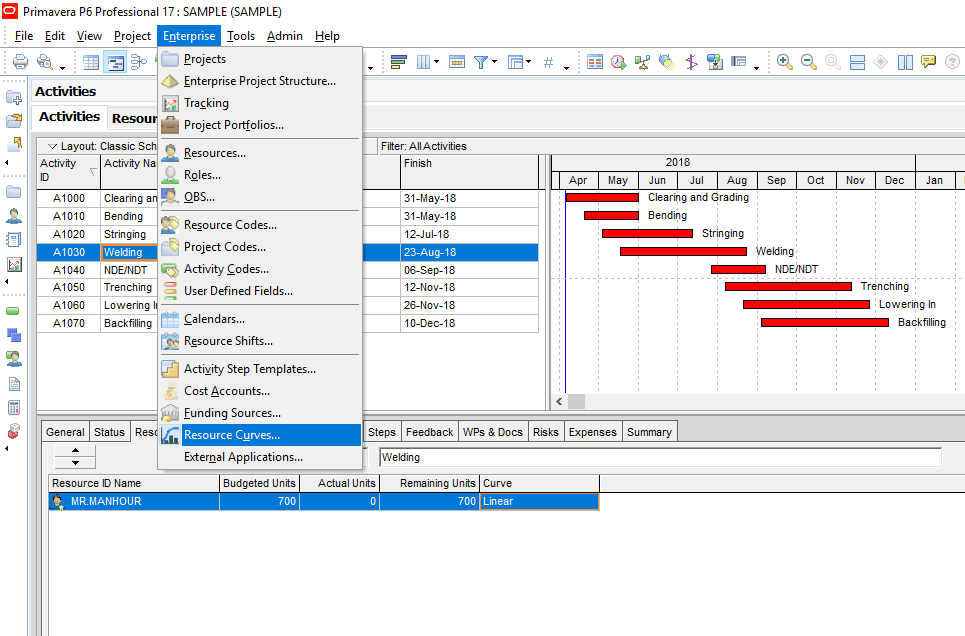

Figure 3 Primavera Resoruce Curves
Primavera P6 Resource Curves – Figure 3 Primavera Resoruce Curves

In the Resource Curves window click “Add” button and select a resource curve template to create your custom curve. (Figure 4)

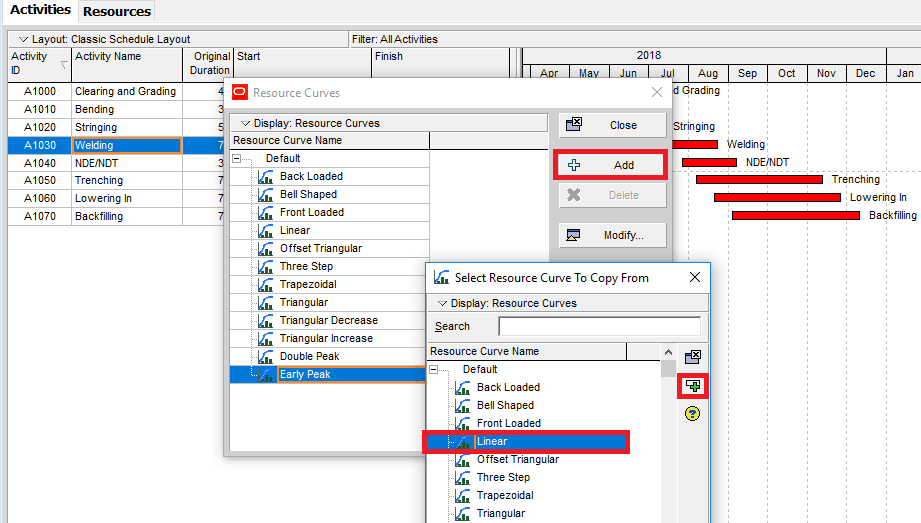

Figure 4 Resource Curves Window
Primavera P6 Resource Curves – Figure 4 Resource Curves Window

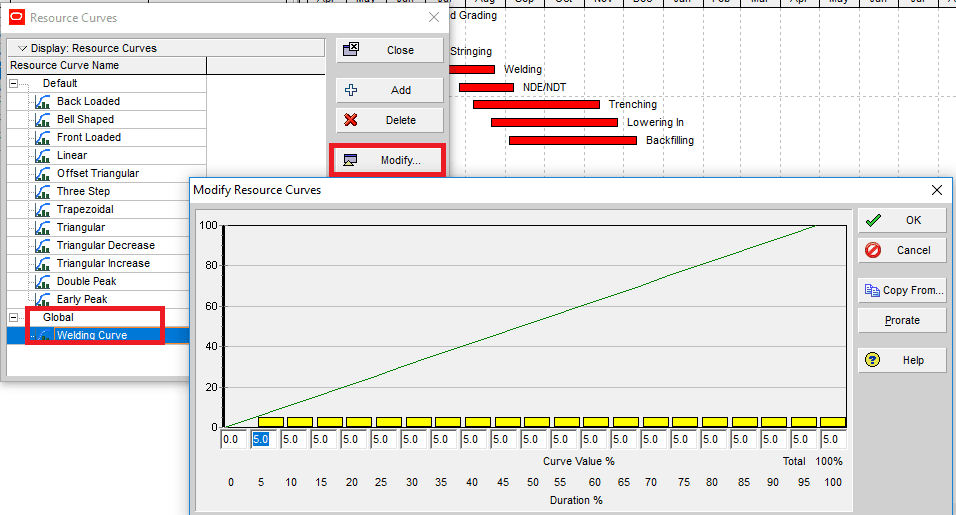

Then, type the new resource curve name as “Welding Curve” and click “Modify” button to customize. (Figure 5)

Figure 5 Welding Curve
Figure 5 Welding Curve

The modify resource curves window allows you to determine a ‘curve value %’ for every ‘duration %’ increment of 5 from 0 to 100. In this example we fill in uniform resource loading for the last four duration period. (Figure 6.)

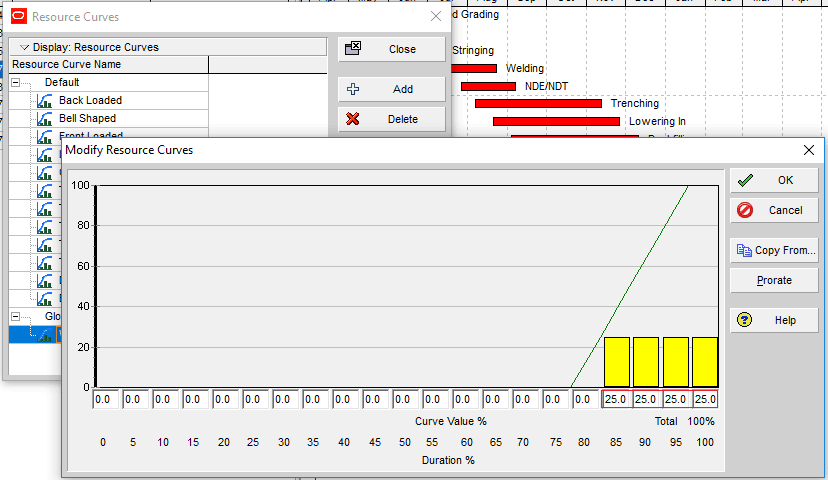

Figure 6 Customizing Resource Curve
Figure 6 Customizing Resource Curve

Now close the resource curves window and assign the newly created “Welding Curve” to the welding activity. (Figure 7.)

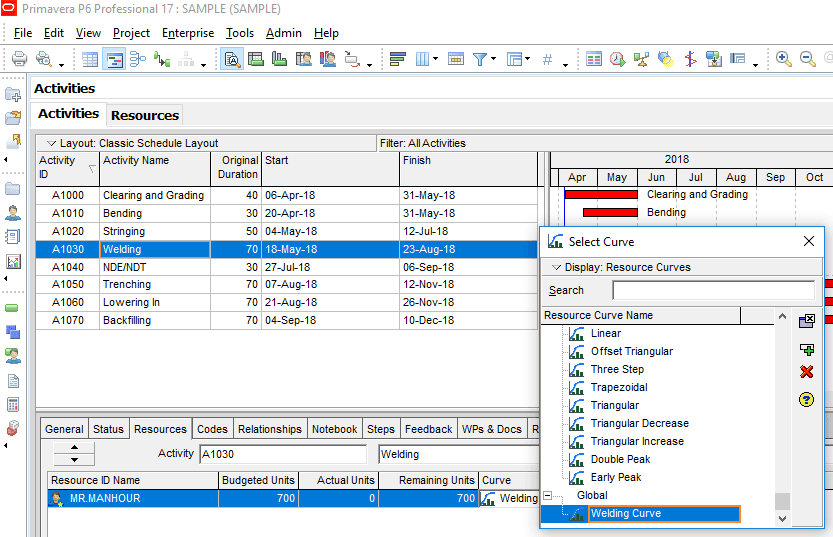

Figure 7 Assigning Resource Curve
Figure 7 Assigning Resource Curve

The Figure 8 displays the resource usage profile of the welding activity. As it is seen from the figure that resource distribuiton of the welding activity is not uniform. It demonstrates the resource distribution of our customized curve.

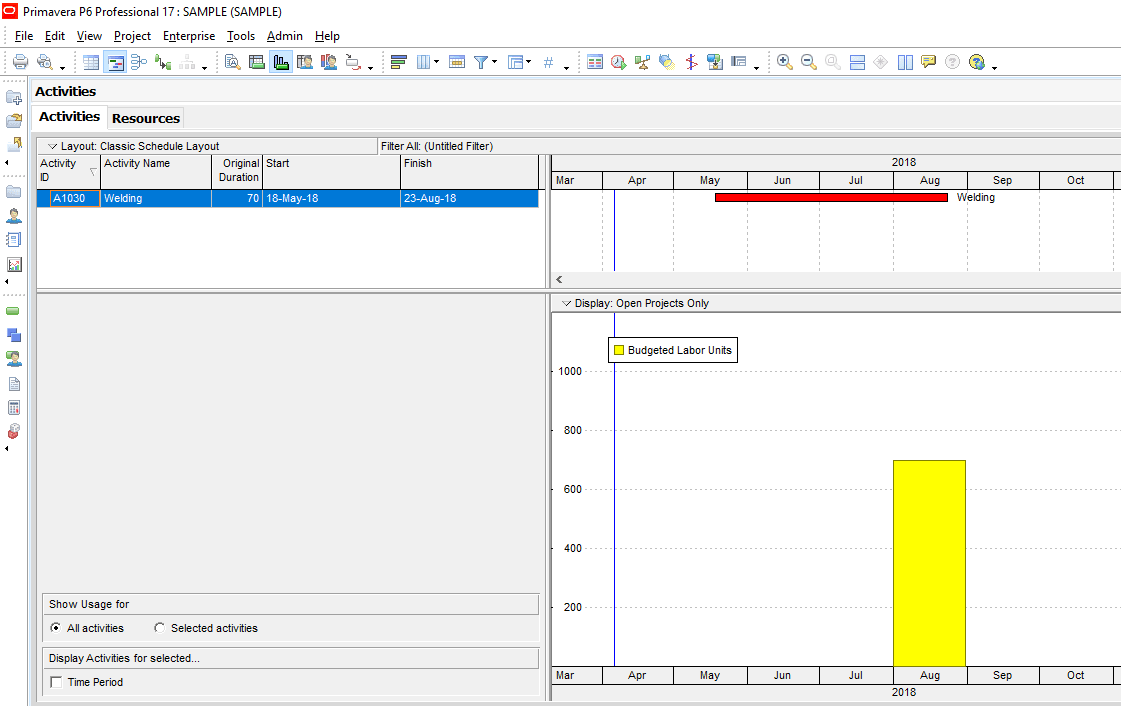

Figure 8 Resource Usage Profile
Figure 8 Resource Usage Profile

Summary

Primavera P6 Resource Curves feature offers several default curves for representing the resource loading of an activity. There are twelve default resource curves defined in the application. [1] It is possible to create a specific resource curve. It is a flexible tool enables you to create your projects custom resource loading tables and analyze them in detail.

References

[1] docs.oracle Defining Resource Curves
