Assigning Expenses in Primavera P6

Assigning Expenses in Primavera P6

Assigning Expenses in Primavera P6

Tracking expenses is a critical process for any projects life cycle. It is very important to forecast and analyze expenses of activities for a succcessful completion. The expense tool of Primavera P6 allows you to assign expenses to activities . By the help of this tool, it is also possible to assign costs to activities without assigning resources. Assigning expenses in Primavera P6 is useful practice to track project expenses in an effective manner.
This article illustrates the assignment of a project specific material expense to an activity in Primavera P6.

What are the Project Expenses ?



Project cost management is an important practice for making project decisions. As a project manager it is your business to plan and track project costs to complete the project on budget. Typically there are five types of costs in a project. These are fixed, variable, direct, indirect and sunk costs. Simply put the people who do the work, like bricklayers and machine operators, are direct costs to the project. On the other hand project managers whose work is supervise people are usually an indirect cost to the project. If you don’t know the difference between direct and indirect cost, you can read the article below.

Direct Cost and Indirect Cost , Cost Classification

Expenses can be transportation, consulting, training costs, wages etc. Direct and indirect costs can be assigned to activities as expenses without using the resources in Primavera P6. The expense tool is useful for project specific material, labor and equipment costs.

How to Assign Expenses in Primavera P6 ?

Now let’s assign expenses in Primavera P6 by using a sample project.

The sample project given below is a pipeline project and you will assign a material expense to the Mechanical Works activity of Block Valve Station-X. (Figure -1)

Assigning Expenses in Primavera P6 Figure 1
Assigning Expenses in Primavera P6 Figure 1

Let’s assume that a specific valve should be installed in order to complete the mechanical works and the cost of the valve is $25,000. You can assign any type of costs such as project-specific material costs, and other non-resource based costs using the ‘Expenses’ tab in the bottom details area. (Figure- 2)

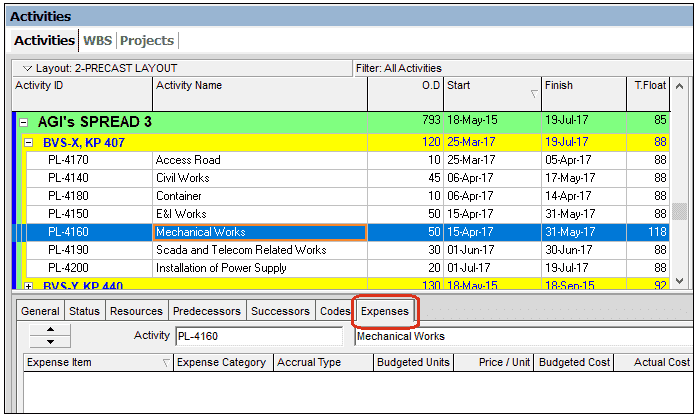

Assigning Expenses in Primavera P6 Figure 2
Assigning Expenses in Primavera P6 Figure 2

Click the + Add button at the bottom left of the screen and enter the Expense Item name and the Expense Category as shown in the Figure 3.

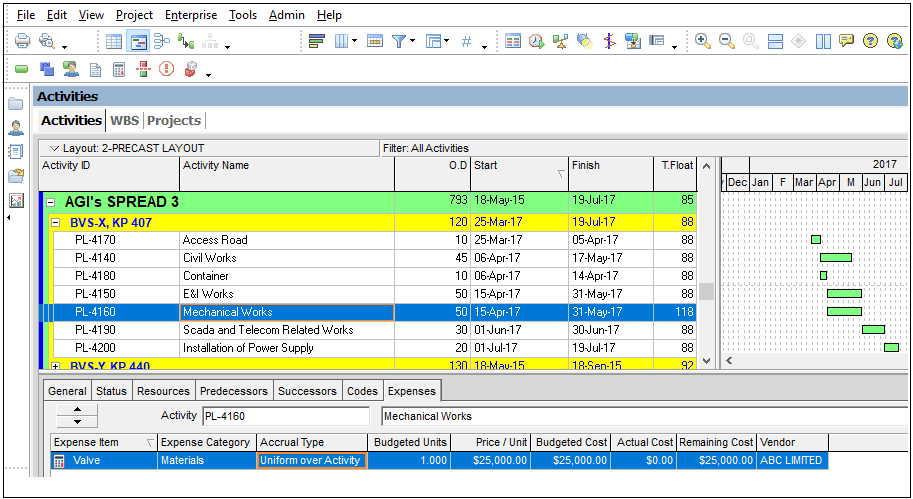

Assigning Expenses in Primavera P6 Figure 3
Assigning Expenses in Primavera P6 Figure 3

You can fill the required cells as shown below.
Expense Item is “Valve”.
Expense Category is “Materials”.
Budgeted Units is 1.
Price/Unit is $25,000.
Vendor is “ABC Limited”.
Accrual Type is Uniform over the Activity. If it is required, you can accrue at the start or finish of the activity by using this cell.

Summary



This article demonstrated how to assign a project specific material expense to an activity in Primavera P6. You can add numerous expenses to an activity by the help of this tool. Also you can add several expense categories by using the “Select Expense Category Window”.
