Analyzing Data Dynamics: Control Chart versus Run Chart

Control Chart versus Run Chart in Quality Control infographic

A few years back I was part of a process review on a batch manufacturing line — the kind of situation where the control chart vs run chart distinction stops being theoretical. The quality team had been chasing a variation issue for about two weeks. They were convinced the process was out of control — data points kept crossing what they called the “limits” on their chart. They’d been tweaking settings, retraining operators, reviewing supplier materials. Nothing was fixing it.

When I finally looked at the chart, the problem was immediately visible — but not the problem they thought they had. The lines they were treating as control limits were actually specification limits. Customer-defined thresholds for acceptable output. The process itself, when you calculated actual control limits from the data, was stable and predictable. The variation they were seeing was entirely normal. There was nothing to fix. They’d spent two weeks optimizing a process that didn’t need optimization, because two different types of lines on a chart had gotten conflated.

That experience is why I find the control chart versus run chart question more interesting than it sounds. The surface-level difference — run charts have a median line, control charts have control limits — is easy to describe. What’s harder to explain is what the control limits actually represent, and what happens when people misread them.

Control Chart vs Run Chart: The Spec Limit Mistake That Matters

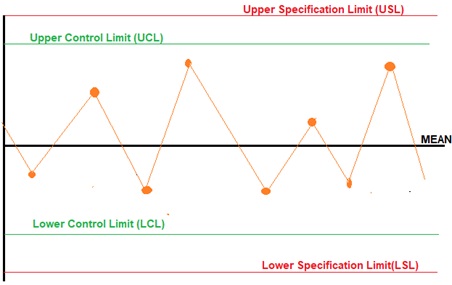

Control limits and specification limits are not the same thing. They don’t mean the same thing, they’re not calculated the same way, and crossing one has completely different implications than crossing the other.

Specification limits come from outside the process — from design requirements, regulatory standards, or customer expectations. They define what’s acceptable. They’re fixed by someone’s requirements, not by the process data.

Control limits are calculated from the process data itself — typically three standard deviations above and below the process mean. They represent the expected range of natural variation when the process is running in a stable state. A point outside the control limits means the process did something statistically unusual. It doesn’t mean the output was unacceptable — that’s the specification limit’s job.

The critical implication: a process can be in statistical control (all points within control limits) and still regularly produce out-of-spec output, if the natural variation of the process is wider than the customer’s acceptable window. And conversely, a process can have individual points outside specification limits while still being statistically in control — if the spec limit is tighter than the process’s natural variation, some out-of-spec output is the expected result of a stable process, not a sign that anything went wrong. The fix in that case is to change the process itself, not to investigate individual data points as anomalies.

The team I mentioned earlier had the second situation. Their process was stable. Some output occasionally crossed the spec limit. They kept investigating individual instances as if each one were a special event, when the right response was a process capability study to understand whether the process, at its normal operating range, could consistently meet the spec — and if not, what would need to change. This is the kind of confusion that makes the control chart vs run chart distinction matter beyond textbook definitions — it changes what action you take.

Control Chart vs Run Chart: What the Run Chart Actually Does

A run chart is a line graph of data over time with a median line drawn across the middle. That’s essentially all it is structurally. What matters is what you’re looking for when you use one.

Run charts are built for detecting patterns — specifically, non-random patterns that suggest something systematic is happening. A run of eight or more consecutive points all on the same side of the median suggests a sustained shift: the process isn’t fluctuating randomly around its center, it’s running consistently higher or lower. A steady upward or downward trend over several points suggests drift. Cycles that repeat at predictable intervals suggest something periodic is influencing the output.

They’re useful as a first look at a process, or when you’re tracking whether an improvement initiative actually moved the needle. You introduce a change, the run chart shows you whether the metric shifted and stayed shifted. That’s genuinely useful, and for that purpose a run chart is often all you need. I use them at the start of most process reviews, before deciding whether more statistical machinery is warranted.

What they can’t do is tell you whether a specific data point represents something to act on or something to ignore. A point that looks dramatic on a run chart might be completely within the normal variation of a stable process. Without calculated control limits, you have no statistical basis for that judgment — you’re making a call based on visual impression, which is unreliable. Below is an example for a typical run chart.

What a Control Chart Adds — and What It Costs

A control chart, developed by Walter Shewhart, adds calculated upper and lower control limits to a run chart’s basic structure. The centerline becomes the mean rather than the median. The control limits are set at three standard deviations from the mean, calculated from the process data itself.

The statistical framework behind control charts is built on the distinction between two types of variation. Common cause variation is the natural, random fluctuation inherent to any process — the background noise of normal operations. Special cause variation is something different: a specific, identifiable event or condition that pushed the process outside its normal behavior. Control limits define the boundary between the two. Points within the limits are common cause. Points outside them — or certain patterns within them — are signals of special causes worth investigating.

This is what you need when you’re making real-time decisions about whether to intervene. In manufacturing, do you stop the line? In healthcare, do you investigate this patient outcome? In software deployment, do you roll back? These decisions benefit from a statistical basis for distinguishing signal from noise — and that’s what control charts provide.

The cost is complexity. Control charts require enough data to calculate meaningful limits — I’ve seen guidance ranging from 20 to 25 data points as a minimum, and I think that’s roughly right. Limits calculated from fewer data points are unreliable, either too wide or too narrow, which makes the chart misleading. There are also multiple chart types — X-bar and R charts for subgroup data, individuals (I-MR) charts for single measurements, p-charts for proportions, c-charts for counts — and picking the wrong type produces wrong limits. A run chart doesn’t have these requirements, which is part of why it’s a better starting point when you’re still figuring out what you’re dealing with. Below is an example for a typical control chart.

Control Chart example and calculation steps

Run Rules: The Part Most People Skip

Control charts don’t only signal when a point goes outside the three-sigma control limits. There are also patterns within the control limits that indicate process instability — run rules, sometimes called the Western Electric rules. In my experience, most people who use control charts know the “point outside the limits” signal but don’t apply the run rules, which means they miss a significant proportion of what the chart is actually telling them.

The ones I use most often:

Seven consecutive points on one side of the centerline — the Rule of Seven. Even with all points inside the limits, a sustained run on one side is statistically unlikely in a truly random process. It suggests a shift in the process mean that’s real but small — small enough that individual points haven’t yet broken through the three-sigma boundary. I’ve found this rule catches slow drifts earlier than waiting for a point to go out of control, which matters when the drift has a cause you can still act on.

Six consecutive points all moving in the same direction — a trend. A steady climb or fall, even within the limits, suggests something is changing systematically over time.

Two of three consecutive points beyond two sigma on the same side — a weaker signal, but one that appears earlier in emerging problems than the three-sigma test.

Run charts have a simpler version of this logic — you look for non-random patterns around the median. But without the sigma-based structure, you can’t apply the two-sigma or seven-point rules. The run chart gives you the pattern; the control chart gives you the statistical thresholds to evaluate the pattern against.

One practical note: more run rules applied simultaneously means more false signals. If you apply all eight Western Electric rules at once on a stable process, you’ll get frequent alerts that don’t correspond to real problems. Most practitioners apply two or three rules — typically the out-of-control point and the Rule of Seven — and add others selectively based on the specific types of shifts they’re monitoring for.


Control Chart vs Run Chart: My Honest Take on When to Use Each

I use run charts when I’m exploring a new process, monitoring whether a change had an effect, or working with data I don’t yet have enough of to support reliable control limits. They’re faster to set up and easier to explain to people who aren’t statisticians, which matters more often than it should in real organizations.

I use control charts when I need to make ongoing decisions about whether to investigate or intervene — when the cost of acting on false signals is real, or when the cost of missing real signals is real. Manufacturing quality lines, clinical processes, any context where decisions have consequences and you need a defensible statistical basis for them.

The transition between the two is often messier than the textbooks suggest. I’ve started with a run chart, accumulated enough data to compute control limits, and then had to explain to the team why some points they’d been treating as signals were actually within normal variation — and vice versa. The run chart gives you an intuition; the control chart tests that intuition against the data.

What I’d push back on is the assumption that control charts are always the superior tool and run charts are just a simpler substitute. Run charts are the right tool for pattern detection and trend monitoring. Control charts are the right tool for signal/noise discrimination in ongoing operations. They’re answering different questions, and using the right one for the question you’re actually asking matters more than always reaching for the more sophisticated option.

Control Chart vs Run Chart in the Seven Quality Tools

Control charts are one of the seven basic quality tools originally catalogued by Kaoru Ishikawa. The others — scatter diagramsPareto chartsfishbone diagrams, histograms, check sheets, flowcharts — don’t require the statistical background that control charts do, which is probably why the control limit versus specification limit confusion persists even among people who’ve been using quality tools for years.

Run charts aren’t in the original seven. They’re widely used in practice as a lighter-weight precursor to control charts, and they show up in lean and improvement methodologies regularly. If you’re preparing for a PMP or Six Sigma exam, be aware that the exam typically references the seven tools by name, and run chart isn’t one of them.

Ishikawa’s original insight was that these seven tools together could address the large majority of quality problems when applied systematically — not that any individual tool was complex, but that having a structured toolkit meant approaching problems methodically. Control charts fit into that toolkit as the ongoing monitoring instrument, the one you put in place after you’ve used the other tools to understand what you’re monitoring and why. The run chart, practically speaking, is often what you use while you’re figuring that out.
